How to estimate tasks

Creating the right environment for estimation #

To produce an estimate that the team has confidence in, we need to set ourselves up for success first. That means that each ticket which requires an estimate should have:

People will probably have preferred ways of doing this work, but here’s a suggested process:

Your own process may change on different projects based upon the projects and team shape. You should document your estimation process and be clear on everyone’s responsibilities.

Getting the numbers #

So, now you have your perfectly curated tickets - you understand the assignment. Now you need to actually estimate. Humans are optimistic in their estimates, we always think we can do more in the time we have. What’s your gut instinct for the estimate?

Now, consider what might slow you down:

The estimate should account for the end to end process - the “cycle time”: from starting the ticket to it being deployed to the live environment (or test environment, depending on the circumstances - some clients will want to review work in the test environment before it gets deployed to a live service).

By including the time needed for a code review and possible feedback, we’re building a picture of how long we think the task will take to be done, rather than just ready for a review.

Getting a task ready to the point of code review is not done from the perspective of the user and can give us overly optimistic estimates. Your estimates should be based on the environment you are in - team shape, project requirements, and domain complexity should all factor into your estimate.

Diagram and key #

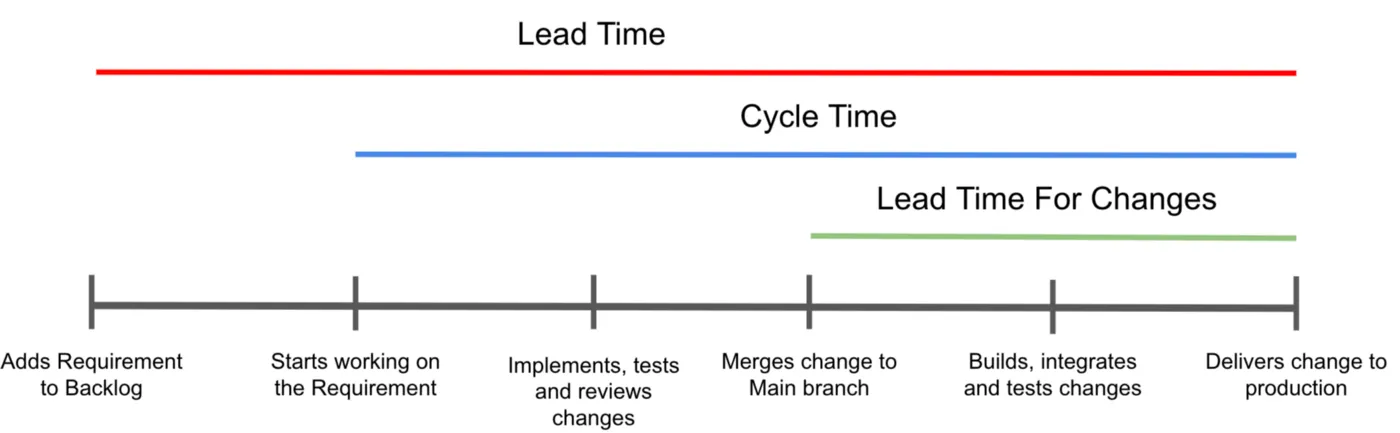

3 coloured lines of different lengths to visualise the difference between lead time, cycle time, and lead time for changes

Lead time: The total time it takes from deciding to do a story, to it being released into production

Cycle time: The actual time you and others will spend working on a story, up until it being released into production

Lead time for changes: The time it takes from merging the change into production to it being in the hands of users

The diagram is sourced from an article about measuring software delivery.

Typically we would like to estimate the “cycle time”. This is because we have less control over when something is prioritised into a sprint and ready to be worked on (first part of overall lead time), and also over how long it takes to get a change into production on client systems (lead time for changes).

We are interested in all the different timings for different reasons. Cycle time shows us how complex tasks are and helps prioritise workload, whilst Lead times help predict when users may see changes and help us plan change control.

When coming up with your estimate, make sure you’re comfortable with the level of detail on the ticket and the definition of done. As mentioned above, this helps the person reviewing and ensures that what you’ve written actually fulfils the scope. It also helps to reduce the risk that we build the wrong thing - the code may be perfect but if it isn’t what is expected, it’s wasted work.

If the estimate for a task is bigger than 2 days, you should consider if it could be broken down into smaller tasks. Generally if a task is estimated to take longer than this, the accuracy of the estimate starts to drop quickly. All tasks however should be broken down smaller wherever possible.

What to do with the numbers #

Once the team has done the estimates, they must be added to the tickets so we can track progress. This can be a useful tool in daily stand ups, where if tickets are progressing at a significantly different pace to the estimate, the team can offer support and the DL/PM can speak to the stakeholders if needed. Tracking the estimates is to help teams better manage their workloads and delivery plans.

When planning work into a sprint with your estimated tickets, do not commit to 100% of your time! For example if you work a 9 day sprint, that doesn’t mean you will be able to complete 9 days worth of tickets. Email, meetings, unplanned work (for example, high priority bug fixes), brain fog, supporting your team - these things all eat into your time, so make sure you factor that into the sprint plan.

Estimates change - communication is key #

This is not about monitoring people or chasing for speed. We need to be able to be honest with each other about progress. It’s not fair on anyone if just one person in the team doesn’t share an honest progress update about how they’re getting on with their work. This is known as “hope creep”, where you don’t confront the reality of the time you need to get the work done.

In the event that your task is taking longer than you thought, flag it with someone who can support - ideally in the daily stand up, if not before, so the rest of the team can support. It might be that you’re less experienced with this particular piece of work, or you’ve hit a wall, or you’re just having a tough time getting it done. Someone else on the team might be able to pair, or rubber duck with you, or suggest a different approach. Someone else might have an idea about how to reduce the complexity. And your DM/PM will need to know if progress is slower than estimated so they can adjust plans accordingly.

Putting it into practice #

Ultimately good estimation starts with a shared understanding: including everyone’s viewpoints, being able to ask questions without fear of judgement, and using these practices to get on the same page as a team.

Our 5 estimation fundamentals #

  1. Ensure psychological safety

    Foster an environment where team members feel comfortable expressing uncertainties, asking questions, and challenging assumptions. This reduces the risk of over-promising and encourages more confident estimates.

  2. Understand the task fully

    Before estimating, make sure the task is well understood by the team, including any design or technical constraints. Clarify the “definition of done” and ensure everyone is aligned on the ticket’s purpose.

  3. Consider potential delays and complexity

    Account for dependencies, code complexity, testing requirements, and the entire process from start to deployment when estimating. Don’t rely solely on optimistic initial impressions.

  4. Break down large tasks

    If a task estimate exceeds 2 days, break it into smaller, more manageable tasks to improve accuracy. Smaller tasks provide better clarity and reduce risk.

  5. Track progress and communicate changes

    Regularly review estimates and communicate any significant changes in task progress. If estimates are off, inform the team early to adjust plans and offer support.


Last updated: 11 March 2025 (history)
